Cost and commercial

Budgets, commitments and actuals on the same links as your P6 programme.

Available nowEverything here is live today.

Cost

Control accounts sit on the schedule, so cost and time tell the same story.

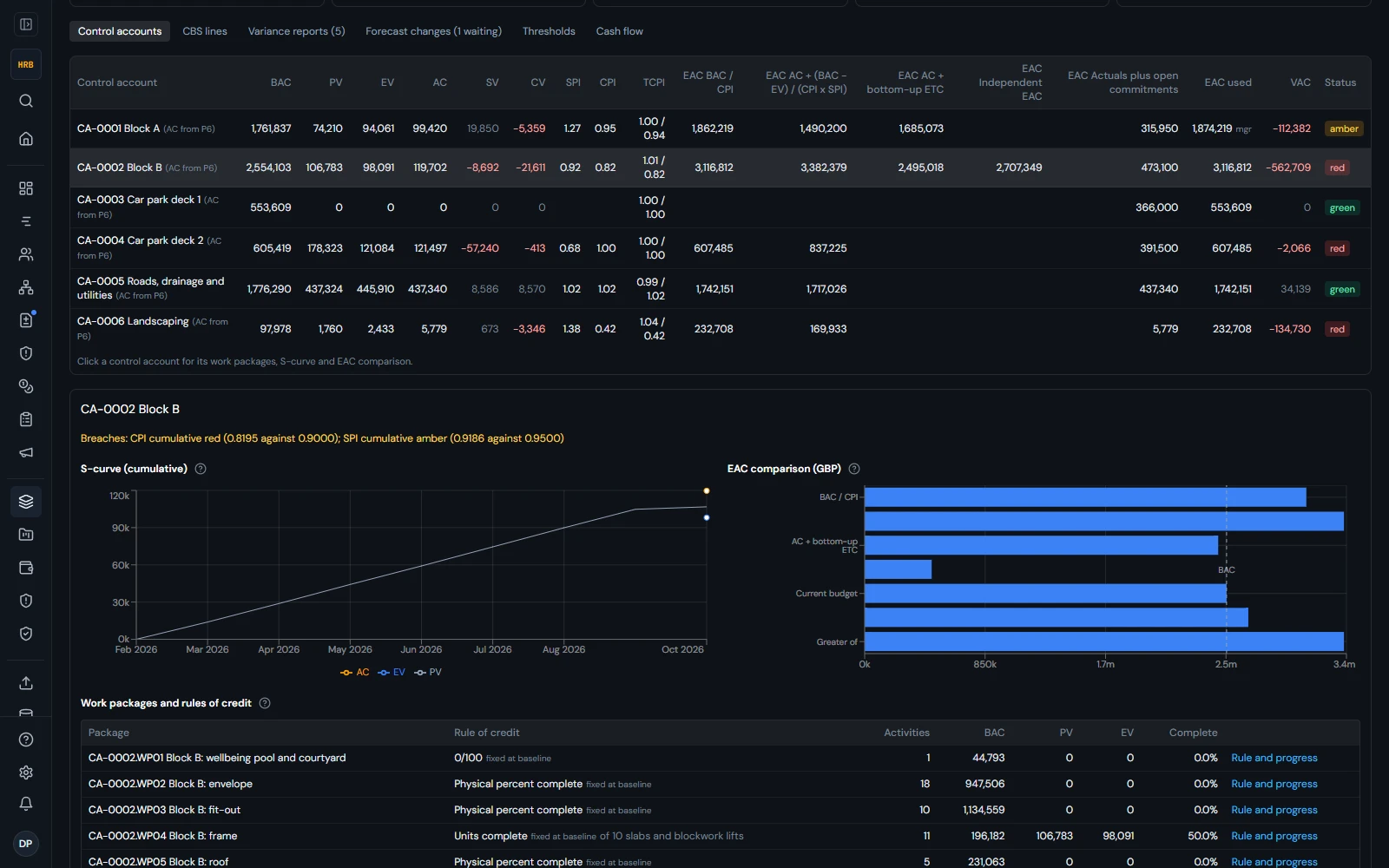

Control accounts mapped to P6 activities with budgets

What you get

Short version first. Book a demo for the long one.

Structure

3 things
  • Control accounts on P6

    Mapped to activities, with the code written back to P6.

  • Who owns what

    OBS, responsibility matrix, work and planning packages.

  • Your coding standards

    Report by ICMS 3, NRM, CESMM4 and Ofgem RIIO.

Estimate and budget

3 things
  • Estimates as a range

    Base cost, escalation, risk and optimism bias, the IPA way.

  • Budgets and baselines

    The baseline and contract budget, with approved transfers.

  • Contingency kept apart

    Contingency and management reserve, each with its own owner.

Commit, spend, accrue

3 things
  • Commitments, phased

    By the schedule, a curve, milestones or resource.

  • Actuals to the invoice line

    Drill down from the control account to the invoice.

  • Accruals and period close

    Accruals that reverse, timesheets, plant and a close checklist.

Measure and report

6 things

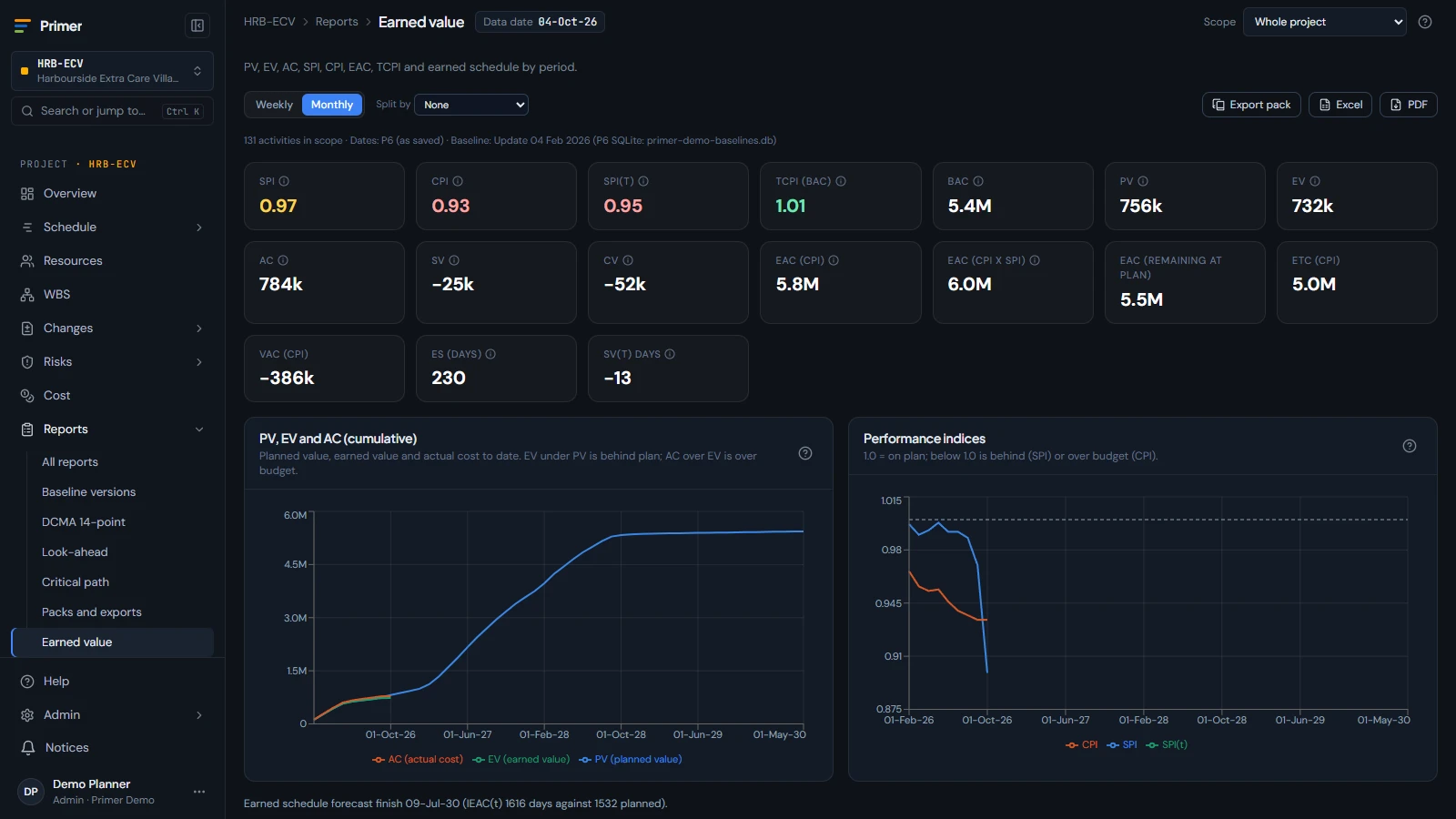

  • Earned value per account

    Forecasts side by side, with variance thresholds.

  • Cash flow

    Spend by period from commitments, actuals and the plan.

  • Round trip to P6

    Costs sent back, so both tools hold the same numbers.

  • Monthly cost pack

    PDF and PowerPoint, in the standard formats.

  • AI first drafts

    A variance narrative checked against the figures, for a person to approve.

  • Carbon with cost

    Carbon budget, actuals and forecast on the same lines.
